Hemlock Project timeline update plus last call to make comments to City Council before 3pm THURSDAY JULY 30th!

7/26/26 POST
UPDATE ON HEMLOCK PROJECT

Hemlock seawall construction is tentatively scheduled to be completed by 8/28/2026.
Construction will accelerate during low tide weeks of 7/29-31 and 8/10-14.
The third week of August will be the pilaster concrete placement.
After the pilasters are done, the contractor will demobilize the staging areas and the scaffolding on the seawall in the last week of August.
Hemlock seawall foundation work (vinyl sheet pile installation) will depend on the delivery of the sheet piles, which will take 4-6 weeks from issuance of Notice to Proceed from the City (~7/30 scheduled City Council meeting for approval).
Sheet pile installation will take about two weeks.
If all goes well, the foundation work can be done by the end of September.
Again, this is a time and cost saving option so that the contractor does not need to return to Hemlock to complete the foundation work at a later time since they are already onsite.
This option became viable this past June when the regulatory agencies notified the City that the construction permits will be ready on 8/14/2026.
Please don’t hesitate to leave comments or contact K J May, the City Engineer if you have any questions.

NEW Notice of work outside hours for August week of 8/10-14
In addition to the 7/29 to 8/1 tide work notice (to start installing the QuakeWrap panels),
there is another notice to work outside work hours week of 8/10-14;
Jilk plans to continue the QuakeWrap panel installation on the West Hemlock/Napoli side of the seawall during 8/10-14 low tide periods.

We do want feedback on this work!

Work Extension 7/29 to 8/1

The Contractor submitted another Tide Work Notice from 7/29 to 8/1, (JILK_Tide_Work_Notice_07_14_2026)

Please note 8/1 is a Saturday and it is just a placeholder for now in case Jilk cannot finish the planned work during the weekdays.

Per the tide chart, low tide begins around 4:30am and the planned work for this period will be the installation of the QuakeWrap panels on the Napoli Drive side, which will be quieter than this week’s shotcrete work on the bottom half of the seawall.

The goal is to wrap up construction by early August and the remaining foundation work to begin after the City Council approval scheduled for 7/30.



REMINDER! comments must be received before 3 pm on Thursday July 30th!

ALSO: Note that this meeting is on THURSDAY!

Action Requested: Support Agenda Item L.6 – West Hemlock Seawall Repairs

Oxnard City Council Meeting – July 30, 2026

July 30, 2026 an important item will be on the consent agenda at the City Council Meeting! If approved the foundation repair work on Hemlock would be added to the existing project. and begin as the current work wraps up. This would prevent residents from experiencing a second round of dock relocations and neighborhood disruption, when the broader project is underway, and provide an additional element to planning for the future.

The Oxnard City Council will consider Agenda Item L.6 on the Consent Calendar, requesting approval of $232,000 in additional funding to complete the foundation repairs for the West Hemlock Street seawall project.

Why is this important?

When the original construction contract was awarded, foundation repairs could not be included because environmental permits had not yet been issued. Those permits are now expected, allowing this work to move forward. Approving the funding now will:

  • Complete the project while the contractor is already on site.
  • Avoid additional mobilization costs and future construction delays.
  • Prevent residents from experiencing a second round of dock relocations and neighborhood disruption.
  • Complete the City’s pilot seawall repair project, which will help guide future rehabilitation of Mandalay Bay’s aging seawalls.

A Long Time Coming

Many residents may remember that this project was originally approved and funded in 2018, but was delayed while additional engineering studies and redesign were completed. Construction costs have continued to rise during those years. Completing the foundation repairs now is the most efficient and cost-effective path forward.

CIWHA Position

The Channel Islands Waterfront Homeowners Association supports approval of this item. We believe completing the project now is in the best interest of both residents and the City, and we encourage the Council to use the knowledge gained from this pilot project to develop a comprehensive long-term plan for rehabilitating the remaining Mandalay Bay seawalls.

CIWHA letter requesting approval:
Oxnard_City_Council_JULY_30_Request-for-approval_Agenda_Item-L_6_CIWHA

How You Can Help

Please consider sending a brief email to the Mayor and City Council before the meeting expressing your support for Agenda Item L.6.

A simple message such as the following is sufficient, feel free to edit:

Honorable Mayor, Members of the City Council, and City Staff:

I support Agenda Item L.6 authorizing the additional funding needed to complete the West Hemlock Street seawall foundation repairs. Completing this work now will save money, reduce future disruption to residents, and help move forward with long-term seawall rehabilitation throughout Mandalay Bay. Please vote YES. Thank you.

(add your name  and resident of Mandalay Waterways 1)

Send the email to: cityclerk@oxnard.org

Subject line: City Council July 30, 2026 Agenda Item L.6. Please approve!

Oxnard City Council Meetings:
https://www.oxnard.gov/city-clerks-office/meeting-agendas

The public is invited to attend city meetings in the City Council Chambers or view them from home on Spectrum channel 10, Frontier channel 35, or streaming on YouTube at www.youtube.com/oxnardnews.

City Council meeting July, 30, 2026
Meeting Location: Council Chambers, 305 West Third Street
July 30, 2026
Appointment Items – 5:30 PM
Regular Meeting – 6:00 PM

All files (https://oxnardca.portal.civicclerk.com/event/5985/files/agenda/11536)

L. INFORMATION/CONSENT AGENDA

Agenda Item Report:
Agenda_Report_Consent-agenda-item-L-6_July-30-2026_PW

6. Public Works Department
SUBJECT: Approve Additional Contract Funds for Additive Bid Item 1, for the Mandalay Bay
Seawalls (West Hemlock Street Seawall Repairs) Project, Specification No. PW 24-129.

RECOMMENDATION: That the City Council approve and authorize additional contract
contingency funding for the execution of Alternate Bid Item 1 in the amount of $232,000 to
Agreement 32600126 with Jilk Heavy Construction for a new not-to-exceed contract value of
$2,664,001.
(This item did not originate in Committee as this is a capital improvement project specifically listed
in the City’s Capital Improvement Program budget, which was previously approved by the City
Council.)
Legislative Body: City Council
Contact: Michael Wolfe, (805) 385-8055



You can attend the meeting in person or virtually, or watch on youtube.
If attending in person 300 West Third Street
Oxnard, CA 93030

you may fill out a comment card prior to the agenda item
.

If attending by zoom you can call in and raise your hand to comment when the agenda item is announced!
Zoom details to call-in for public comment during a meeting:
1. Dial Phone Number: (888) 475-4499
2. Enter Meeting ID: 840 0773 5382
3. Passcode: 403847
If you wish to speak during public comments or a particular item on the agenda, please sign-on by following the
zoom call-in steps listed above.
Once the presiding officer calls for public speakers, press *9 to raise your hand
to inform the City Clerk you would like to speak during the public speaking section for that particular item on
the agenda, while in the zoom waiting room.
Press *6 when asked to unmute. Listen to the instructions
provided virtually on the phone while on hold in the zoom waiting room. Please note that there is a slight time
delay when viewing the meeting via television.

The public is invited to attend city meetings in the City Council Chambers or view them from home on Spectrum channel 10, Frontier channel 35, or streaming on YouTube at www.youtube.com/oxnardnews.



First July  update

HEMLOCK COMING UP NEXT

The last phase of phase of the Hemlock project is expected to begin begin following the resurfacing work.
This will (hopefully) be the Seawall Foundation Repairs (work at the base of the wall).
This is the work with the big map for locations indicated in yellow – download or open the image below in a new tab:
https://channelislandsca.com/wp-content/uploads/2026/02/Mandalay_Seawall_Repairs_Map-2-5-2026-scaled.png
https://channelislandsca.com/wp-content/uploads/2026/02/Mandalay_Seawall_Repairs_Map-2-5-2026.pdf

Hemlock is the only location scheduled for foundation work at this time!

Once completed there are no further known seawall projects  for this block on Hemlock.The Hemlock project is an R&D project that will determine methodology for areas in many areas of the Harbor.
In order to fund the work we want to have the best understanding of process, impact, outcome and cost.

Please provide feedback on the Hemlock Project!

Please leave comments on this page below.
NOTE: comments will not go live the moment you post them.

To prevent the page filling up with spam all comments will be reviewed prior to approval to go live.
Please provide your location so we can map impact. I will remove personally identifying information prior to posting live, but do want track on a map for feedback and any followup needed.

We want to hear about your experience, good,  bad and indifferent!
Homeowners on Hemlock and surrounding locations impacted by construction noise,  parking disruption, or any other observations or experiences!



Hemlock project extended work hours July 13-17 2026

Hemlock Seawall Project: Extended Work Hours Scheduled July 13–18 to Accommodate Low Tides

Hemlock Seawall Project – Extended Work Hours (July 13–18, 2026)
To take advantage of low tide conditions, work hours for the Hemlock seawall project will be temporarily extended during the week of July 13 through July 18, 2026.
The City has heard residents’ concerns regarding the pace of the project, and these extended work hours are intended to help accelerate progress.

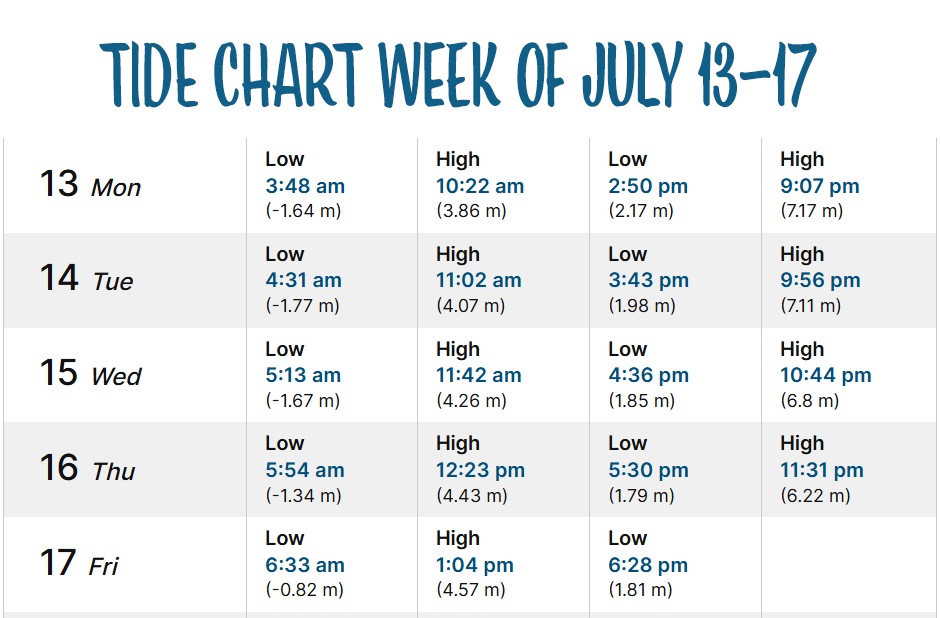

Jilk Heavy Construction will perform tide-dependent work during this period. Depending on tide conditions, work may begin at any time between 12:00 a.m. and 5:00 a.m. on any day during that week.

Please be aware that there will be noise during these early morning work hours. A generator is required to perform this work and will be operating on the lower west portion of the seawall.

A City of Oxnard project representative will be on site during these operations.

There will be an Oxnard project person on site, also if you have concerns you can call the Public Works Sr. Project Manager K.J.May, who we are very happy to welcome back following a deployment!  Thank you to Tamara Ojeda – Project Manager, who stepped up in his absence!

KJ May – Sr. Construction Project Manager
Public Works Department, Engineering
305 West Third Street, East Wing, Second Floor
O: 805.393.3871
